Last updated: 19 November 2026. Every new stadium, stand rebuild and major expansion in UK football, sorted by how real it is: on site now, approved, still on paper, or dropped. Reviewed monthly.
Every UK stadium project at a glance
| Club | Project | Capacity after | Stage | Target |
|---|---|---|---|---|
| Luton Town | New stadium at Power Court | 25,000 | Under construction | 2028/29 |
| Aston Villa | North Stand rebuild, Villa Park | 50,000+ | Under construction | 2027/28 |
| Leeds United | West Stand, then North Stand, Elland Road | c. 47,000, then 53,000 | Under construction | End of 2028, then 2030 |
| Wrexham | New Kop, Racecourse Ground | c. 18,000 | Under construction | 2027/28 |
| Crystal Palace | New Main Stand, Selhurst Park | 34,000+ | Under construction (funding gap) | 2028 |
| Bournemouth | New South Stand and corners, Vitality Stadium | 20,000+ | Under construction | 2027 |
| Nottingham Forest | New Peter Taylor Stand, City Ground | 45,000 (52,500 later) | Approved, start not before 2027 | TBC |
| Oxford United | New stadium at The Triangle, Kidlington | 16,000 | Approved, awaiting start | Before June 2028 |
| Forest Green Rovers | Eco Park timber stadium, Eastington | 5,000 | Approved, no start date | None announced |
| Manchester United | New 100,000-seat stadium next to Old Trafford | 100,000 | Site secured, no planning application yet | None announced |
| Birmingham City | Powerhouse stadium, Bordesley Green | 62,000 | Design unveiled, planning application due | 2030/31 |
| Newcastle United | Expand St James' Park or new stadium next door | 65,000 to 70,000 | Decision pending | Not before 2030 |
| Dundee | New stadium at Camperdown Park | 12,500 | Awaiting planning decision | TBC |
| Chelsea | Stamford Bridge rebuild or relocation | c. 60,000 | Stalled | Not before 2027 start |
| Cambridge United | Possible new stadium at Cambridge East | 15,000 | Feasibility study | TBC |
| Ipswich Town | Cobbold Stand rebuild, Portman Road | TBC | Long-term masterplan | TBC |
| Wealdstone | New stadium in Uxbridge | 6,300 | Site exclusivity to 2028 | By 2031 |
| Peterborough United | New stadium, Embankment preferred | up to 25,000 | Site dispute | TBC |
| QPR | New stadium on the Linford Christie site | 30,000 | Needs council support | TBC |
| Arsenal | Emirates Stadium expansion | n/a | Shelved (October 2026) | n/a |
Contents: Under construction | Approved and waiting | At the planning stage | Recently completed | Shelved, scrapped or dormant | Questions we get asked
Under construction right now
Luton Town: Power Court
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fluton-power-court-stadium-render.jpg)
Luton's long-promised move from Kenilworth Road is finally happening. After 18 months of groundworks on the old power station site in the town centre, including diverting the River Lea, structural piling began in January 2026 and the stands started rising above ground over the summer. Footage from October 2026 shows work on all four stands, with the West Stand the furthest along.
The finished ground will hold 25,000, cost around £100m and open for the 2028/29 season. Read our Power Court guide for the month-by-month timeline.
Aston Villa: North Stand
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fvilla-park-north-stand-render.jpg)
Villa chose speed over comfort. Rather than rebuild the North Stand over several seasons, the club closed it for the whole of 2026/27, which cuts Villa Park to roughly 37,000 this season but means the new stand, with around 12,000 seats instead of 5,000, is ready for 2027/28 and for Villa Park's role as a Euro 2028 host venue. The roof came off at the end of summer 2026 and piling has been visible in drone footage through the autumn.
The project is budgeted at £100m to £110m and takes the ground past 50,000, with the club talking about 52,500 in the longer term. Our Villa Park expansion page has the latest pictures.
Leeds United: Elland Road
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Felland-road-west-stand-render.jpg)
Planning permission arrived in January 2026 and the first demolition, of the West Stand banqueting suite, followed in June. The new West Stand is being built over the top of the old one, so the existing stand stays open throughout 2026/27 while piling and groundworks continue behind it. Capacity on that side rises from about 8,000 to roughly 17,500, taking Elland Road to around 47,000 by the end of 2028.
Phase two is the North Stand, pencilled in for 2029 to 2030, which would bring the total to 53,000 and make Elland Road a UEFA category four venue. Rail seating is also going into the South Stand. Full story on our Elland Road expansion page.
Wrexham: the new Kop
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fwrexham-kop-stand-render.jpg)
McLaren Construction broke ground on the Racecourse Ground's new Kop in December 2025, and the steel frame and roof truss went up through 2026. The stand was originally approved at 5,500 seats; a revised application takes it to 7,750, which would push the Racecourse past 18,000. The club's owners have told fans the stand will be fully open for 2027/28, with some seats possibly in use in the closing months of 2026/27.
Track the build on our Wrexham Kop page.
Crystal Palace: Main Stand
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fselhurst-park-main-stand-render.jpg)
Eight years after planning permission was first granted, Palace started demolishing the 1924 Main Stand in summer 2026, having bought and cleared the houses on Wooderson Close that stood in the way. The replacement is a glass-fronted, multi-tier stand with roughly 13,500 seats, up from 5,200, lifting Selhurst Park above 34,000 by 2028.
One caveat: in October 2026 it emerged the club is looking for outside investment to fund the rest of the build, with Raine Group running the process. The work has not stopped, but the finishing date depends on that money arriving. See our Selhurst Park expansion page.
Bournemouth: South Stand
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fvitality-stadium-south-stand-render.jpg)
Having bought the freehold of the Vitality Stadium in 2025, Bournemouth won approval for an £85m expansion in May 2026. The temporary South Stand came down over the summer, the north-west and south-east corners were filled in early this season, and the upper tier of the new 7,000-seat South Stand is being built around the Premier League fixture list during 2026/27. The North and East stands follow in the 2027 close season.
When it is all done the ground will hold just over 20,000, nearly double what it was. Our Vitality Stadium guide covers each phase.
Approved and waiting for the diggers
Nottingham Forest: City Ground
Forest have changed their mind about the scale of this more than once. The 2019 plan was a 10,000-seat Peter Taylor Stand and a 38,000 ground; the version approved by Rushcliffe council in June 2025 was for 35,000; then in January 2026 the club filed a far bigger scheme with a 58-metre stand, a target of 45,000 and an outline application to enlarge the Brian Clough Stand later for up to 52,500. That bigger plan received conditional approval in September 2026, together with the filling of both Trent End corners.
Enabling works have been lined up to limit disruption later, but the club does not expect to start demolishing the Peter Taylor Stand before 2027. Details on our City Ground expansion page.
Oxford United: The Triangle
Cherwell council approved the 16,000-seat, all-electric stadium near Oxford Parkway in August 2025, the government declined to call it in that October, and the legal agreements were signed in February 2026. Campaigners opposed to building on the green belt launched legal action in April 2026. Oxford have a licence to stay at the Kassam Stadium until June 2028, so that is the real deadline. The scheme, costed at £130m to £150m, includes a hotel and conference centre.
Forest Green Rovers: Eco Park
Zaha Hadid's timber stadium beside junction 13 of the M5 has had outline consent since 2019 and reserved matters approval since December 2024, but a year and a half on there is still no construction start and no completion date. The 5,000-seat ground is part of a wider business park development by Ecotricity. More on our Forest Green stadium page.
At the planning stage
Manchester United: the new Old Trafford
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fmanchester-united-new-stadium-masterplan.jpg)
United confirmed in March 2025 that they would build a new 100,000-seat stadium rather than rebuild Old Trafford. In June 2026 the club bought a 25-acre site about 350 metres north-west of the current ground, and in July 2026 it published a masterplan placing the stadium at the heart of a 370-acre regeneration zone run by a mayoral development corporation. Old Trafford stays in use while the new ground goes up.
What is still missing is a planning application, a construction start date and a confirmed cost, with £2bn the figure most often quoted. Our Old Trafford page keeps the running timeline.
Birmingham City: the Powerhouse
/https%3A%2F%2Fmedia.footballgroundguide.com%2Fmain%2F2026%2F11%2Fbirmingham-city-new-stadium-render.jpg)
Knighthead unveiled the Heatherwick Studio and MANICA design for a 62,000-seat stadium at Bordesley Green in November 2025. It anchors a Sports Quarter on the former Birmingham Wheels site, a short walk from St Andrew's, with a women's stadium, an arena, training facilities and a new tram link. A planning application is expected in 2026 and the club is aiming to open for 2030/31. Read our Birmingham City new stadium page.
Newcastle United: St James' Park or next door?
Five years after the PIF takeover, Newcastle still have not chosen between expanding St James' Park to around 65,000 and building a new 70,000-seat bowl on the adjacent Leazes Park land, a project put at £1.2bn to £1.5bn. The club bought most of the Grade I-listed Leazes Terrace in May 2026, removing a long-standing obstacle to either option, and spent £30m on a summer refresh of the existing ground. Reports in 2026 suggest the new-build option is favoured, but the club says all options remain open. Our Newcastle stadium page has the detail.
Dundee: Camperdown Park
Dundee bought the Camperdown land in 2016 and lodged planning permission in principle for a 12,500-seat stadium in February 2024. The application has missed one committee date after another, most recently because a redesigned junction on the Kingsway triggered a fresh public consultation in autumn 2026. The club says every document the council asked for has been supplied. Latest on our Dundee stadium page.
Chelsea: Stamford Bridge
Chelsea own the Stoll land next to Stamford Bridge, which opens up a rebuild on the current site, but the terms of that purchase mean nothing can start before 2027. A planning application was filed and then paused over construction costs, the Earl's Court alternative has gone to a housing developer, and the Chelsea Pitch Owners complained in 2026 of no substantive progress after three and a half years. Full timeline on our Chelsea new stadium page.
Cambridge United: Abbey Stadium or Cambridge East
The plan to rebuild the Abbey to 12,000 was paused in 2025 on cost grounds. In November 2026 the club agreed to study a 15,000-seat stadium at the Cambridge East development, next to a planned new railway station, with the Hill Group and the Greater Cambridge Development Corporation. No decision to leave the Abbey has been taken.
Ipswich Town: Cobbold Stand
The 1971 Cobbold Stand is the oldest at Portman Road and its replacement has been club policy since the 2021 takeover, but Mark Ashton has repeatedly said there is no timescale. Ipswich have an in-principle agreement for land behind the stand and the council's masterplan for the area, including a multi-storey car park due by the end of 2027, leaves room for it. In the meantime the West Stand concourse was enlarged over summer 2026.
Wealdstone: Uxbridge
Hillingdon council gave Wealdstone a three-year exclusivity agreement in March 2025 on two sites in Uxbridge for a 6,300-seat ground. In March 2026 the club signed a new lease at Grosvenor Vale to 2036, with incentives to leave by May 2031, which sets the timetable. See our Wealdstone stadium page.
Peterborough United: the Embankment
Posh have wanted a new ground on the Embankment since 2020 and the combined authority mayor is pushing a 25,000-seat arena through the government's Stadium Regeneration Accelerator. The city council leader has called the Embankment a non-starter, so the location is unresolved. Background on our Peterborough stadium page.
QPR: Linford Christie Stadium
QPR regard a 30,000-seat ground on the council-owned Linford Christie athletics site as the only way to stay in W12, and have called Loftus Road unsustainable. Hammersmith and Fulham council has yet to back the idea, so there is no application and no date.
Recently completed (2020 to 2026)
Manchester City: North Stand (May 2026)
The £300m Etihad project added a new tier to the North Stand, renamed the Pep Guardiola Stand on the final day of 2025/26, and took capacity to 61,000, along with a hotel, museum and covered fan zone.

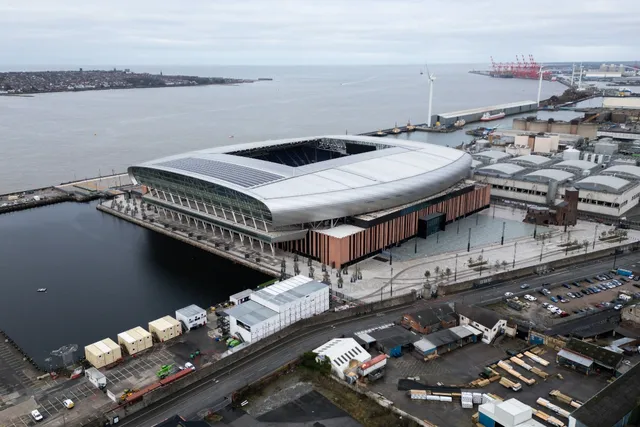

Everton: Hill Dickinson Stadium (August 2025)
Everton left Goodison Park for the 52,800-seat ground at Bramley-Moore Dock at the start of 2025/26. The steep South Stand holds about 13,000 and has drawn the inevitable comparisons with Dortmund's Yellow Wall. See our Everton stadium page.
Fulham: Riverside Stand (2025)
Begun in 2019 and delayed by the pandemic, the hospitality-heavy Riverside Stand fully reopened in May 2025, taking Craven Cottage to 29,600.
Liverpool: Anfield Road (2024)
The remodelled upper tier of the Anfield Road End opened late in 2023/24, lifting Anfield to 61,000 and removing the restricted-view seats below.
Portsmouth: Fratton Park (2024)
A £12m programme reprofiled the North and South stands and rebuilt the Milton End as a 3,200-seat all-seater with rail seating, finished in January 2024 and returning Fratton Park to a capacity above 20,000. Our Fratton Park guide has the full story.
Lincoln City: Stacey West Stand (2024)
The extension to around 3,400 seats, first approved in 2020, was completed in August 2024, with a 70,000-litre rainwater tank thrown in. Details on our Lincoln page.

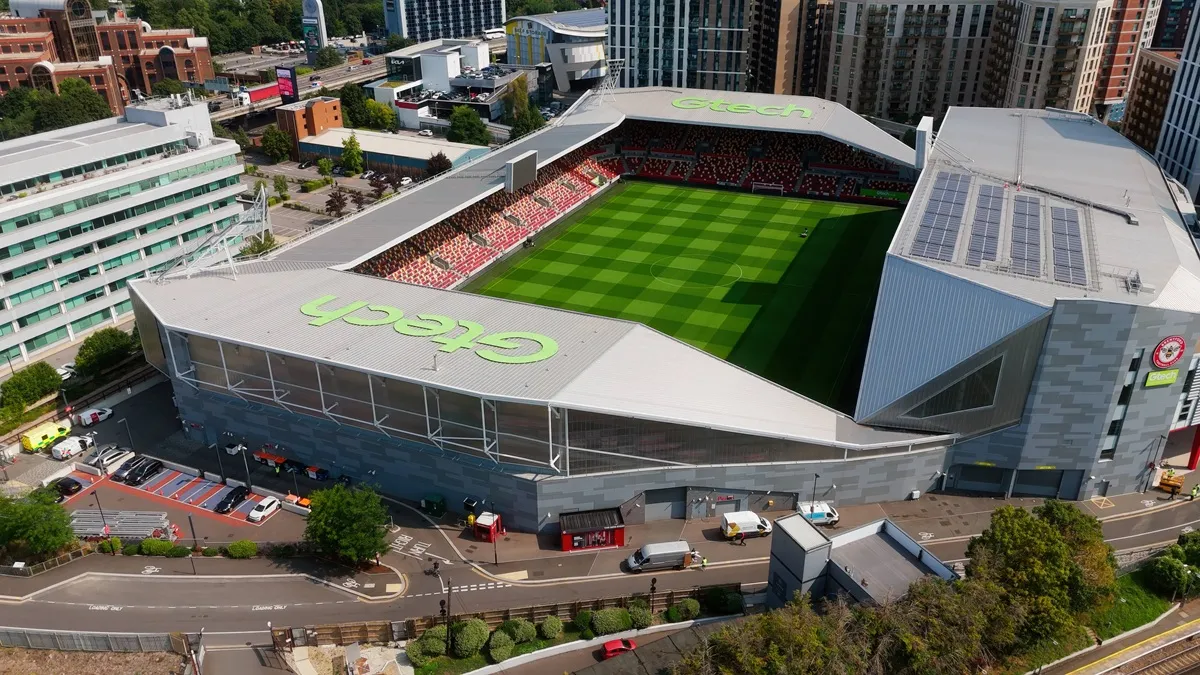

Brentford: Gtech Community Stadium (2020)
Proposed in 2002, started in 2017 and opened on 1 September 2020 at a cost of just over £70m, a few hundred metres from Kew Bridge station and a world away from Griffin Park.
AFC Wimbledon: Plough Lane (2020)
Wimbledon went home on 3 November 2020 to a 9,000-capacity ground built a few hundred yards from the original Plough Lane, for a little over £30m.
York City: York Community Stadium (2021)
Planning permission in 2015, building work from December 2017, completion in December 2020 and a first match on 16 February 2021: the 8,500-seat ground is shared with York Knights rugby league club.
Boston United: Jakemans Community Stadium (2020)
Boston's 5,000-capacity replacement for York Street opened in December 2020 after seven years in the making, with a 3G pitch and murals of the club's history inside the main stand.
Gloucester City: Meadow Park (2020)
Gloucester returned to a rebuilt Meadow Park in 2020, with the playing surface raised about ten feet to keep the River Severn out after the floods of 2007.
Shelved, scrapped or dormant
Formally dropped, or no movement for years.
- Arsenal: after two years of work on taking the Emirates towards 70,000 or more, the club announced in October 2026 that it would not pursue a major expansion and will spend on hospitality, retail and safe standing instead. Capacity stays at about 60,700.
- Barnet: the 7,000-seat New Underhill stadium on Barnet Playing Fields was refused in July 2025 on green belt grounds. The club dropped its appeal in January 2026 and supporters are now working with the council on four or five alternative sites.
- Southend United: the 21,000-seat Fossetts Farm stadium was scrapped in 2024 under new ownership. The club is staying at Roots Hall, with housing at Fossetts Farm helping to pay for upgrades there.
- Woking: the Cardinal Court scheme for a 10,000-seat ground at Kingfield funded by flats was refused and the appeal dismissed. There is no live stadium application.
- Wolverhampton Wanderers: the 2019 plan to rebuild the Steve Bull Stand and South Bank towards 50,000 was shelved during the pandemic and remains on the back burner after relegation in 2025/26.
- Sheffield United: the 5,400-seat South Stand extension approved in 2018 has never started and looks increasingly remote amid ownership uncertainty in 2026. Attention has turned to repairing the Bramall Lane End upper tier instead.
- Scunthorpe United: the Glanford Park expansion died with the club's financial collapse. The ground was bought by a community interest company in November 2023 and the surrounding land is earmarked for homes and jobs.
- Tranmere Rovers: Wirral council approved a feasibility study for a 15,000-seat stadium at Bidston Moss in June 2022, but nothing has come of the Sports City idea since.
- Swansea City: the 2012 plan to extend the East Stand towards 32,000 was never built. The club agreed to buy the Swansea.com Stadium from the council in July 2026 and is adding a fan park rather than seats.
- Charlton Athletic: the long-held permission to take The Valley to 30,900 remains unused. The club extended its lease to 2040 in 2025 and has concentrated on pitch, floodlight and screen upgrades.
- Hull City, Ipswich (West Stand aside), Leicester City, Norwich City, Rotherham United, Shrewsbury Town, Walsall, Watford, West Bromwich Albion, Yeovil Town, Derby County, Crewe Alexandra, Colchester United and Sheffield Wednesday: all have talked about filling corners, adding tiers or a new stand at some point in the past decade. None has a live application.
Questions we get asked
Which new football stadiums are being built in the UK right now?
One brand new ground is under construction, Luton's Power Court, due to open in 2028/29. Five existing grounds have a stand being rebuilt or extended this season: Villa Park, Elland Road, the Racecourse Ground, Selhurst Park and the Vitality Stadium. Everton's Hill Dickinson Stadium and Manchester City's enlarged North Stand both opened within the past 18 months.
What is the biggest stadium project planned in England?
Manchester United's proposed 100,000-seat stadium next to Old Trafford, expected to cost around £2bn. Birmingham City's 62,000-seat Powerhouse and Newcastle's choice between a 65,000 St James' Park and a 70,000 new build come next.
How do you decide which stage a project is in?
“Under construction” means contractors are on site and the work is visible. “Approved” means full planning permission is in place but no main contract has started. “Planning stage” covers everything from a stated ambition to a lodged application. “Shelved” means the club has dropped the scheme or there has been no progress for several years.
